How Much Should a 10×10 Kitchen Remodel Cost in 2026

10x10 kitchen remodel cost example showing white shaker cabinets, quartz countertops, subway tile backsplash, and herringbone LVP flooring in a bright modern kitchen

Most homeowners expect one tidy number. What they get online is a mess of figures that can differ by $80,000. Here’s the short version.

Quick answer: A basic 10×10 kitchen update usually lands between $10,000 and $35,000, a mid-range overhaul between $35,000 and $70,000, and a custom, high-end rebuild between $70,000 and $120,000 or more. Cabinets take the biggest slice, roughly a third of the budget, and a good contingency fund adds another 10 to 20 percent on top.

That’s the headline 10×10 kitchen remodel cost for 2026. The rest of this guide explains why your own number could sit anywhere inside those ranges. At San Diego Home Remodeling, the most useful thing we can give you is a way to read a quote, so you’ll find a checklist for that too.

What a 10x10 Kitchen Really Means

A 10×10 kitchen is a pricing template, not a rule about your room. It means 100 square feet, an L-shaped layout, and about 20 linear feet of cabinets. A linear foot is simply one foot of cabinet run measured along the wall. Contractors use this standard so quotes can be compared fairly.

Your kitchen may be 8×12 or a skinny galley, and the template still applies. So price your project by cabinet run, counter area, and how many things have to move, not by room size. Two kitchens with the same footprint can differ by thirty percent if one keeps the sink and range where they are and the other relocates both.

Average 10x10 Kitchen Remodel Cost in 2026

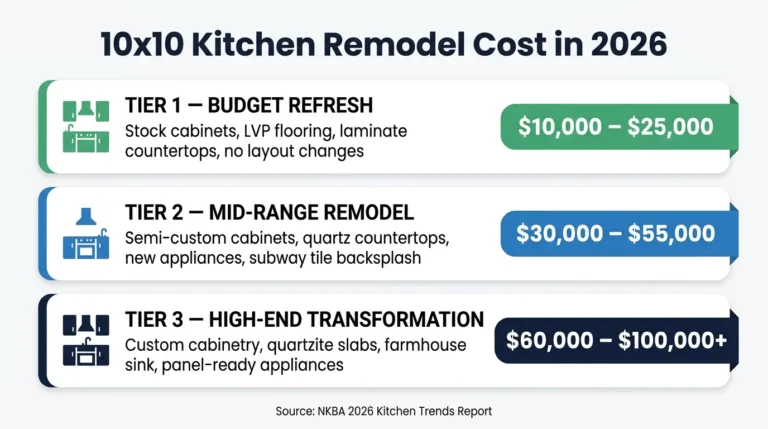

Infographic showing average 10x10 kitchen remodel cost in 2026 across three tiers — budget refresh $10,000–$25,000, mid-range remodel $30,000–$55,000, and high-end transformation $60,000–$100,000+

The average 10×10 kitchen remodel cost depends on how much you change. Tariffs on imported cabinets and tight trade labor have pushed prices up over the past couple of years, and San Diego quotes often sit in the upper half of national ranges. Here are the three tiers:

  • Basic, about $10,000 to $35,000. The layout stays. You get stock cabinets, laminate or entry-level quartz counters, and standard or reused appliances. The low end means keeping most things and painting or refacing. The high end usually means replacing counters and appliances too.
  • Mid-range, about $35,000 to $70,000. Semi-custom cabinets, mid-tier quartz or granite, a new mid-range appliance set, better flooring, and improved lighting.
  • High-end, about $70,000 to $120,000+. Fully custom cabinetry, luxury stone slabs, professional-grade appliances, and often structural or layout changes.

You’ll also hear the 10×10 kitchen renovation cost quoted per square foot. Treat that carefully. Small kitchens cost more per square foot than large ones, because the sink, appliances, permits, demolition, and setup don’t shrink along with the room. A tight 100 square foot kitchen at a high per-foot price isn’t a rip-off. It’s just dense work in a small space.

Where the Money Goes, Line by Line

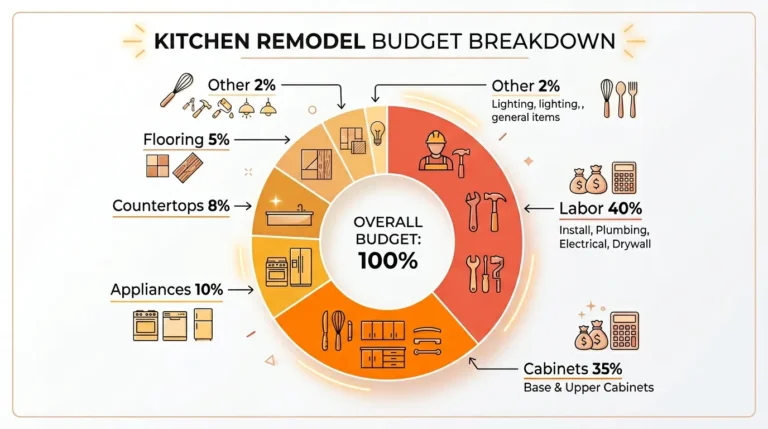

Kitchen remodel budget breakdown donut chart showing 10x10 kitchen remodel cost split labor 40%, cabinets 35%, appliances 10%, countertops 8%, flooring 5%, and other 2%

Here’s a useful way to see your 10 by 10 kitchen remodel cost: as a pie. Cabinets take about 30 to 40 percent. Labor and installation range from 20 to 50 percent, depending on how much plumbing and electrical moves. Appliances take 10 to 20 percent, countertops 10 to 15 percent, and a healthy contingency 10 to 20 percent. These shares overlap a bit, since every project is different, but they show you where to look first when trimming.

Cabinets: Your Biggest Line Item

Stock cabinets start around $2,000 to $5,000 for a kitchen this size, semi-custom runs higher, and fully custom can pass $20,000. Installation is extra. If your existing boxes are structurally sound, refacing (new doors and drawer fronts on the same boxes) can cut the cabinet cost sharply and still change the look completely.

Imported stock cabinets have been affected by tariffs, and the rules have shifted more than once. Ask your contractor how long a quoted cabinet price is held, and get that date in writing.

Countertops, Flooring and the Rest

Countertops range from budget laminate to quartz or granite at roughly $60 to $120 or more per square foot installed. A 10×10 layout needs around 35 to 50 square feet, so material choice swings the total by thousands.

Appliances are the other big swing. A standard package typically runs $2,000 to $5,000 or more, and designer lines climb much higher. Flooring, backsplash tile, and lighting are smaller lines, but they add up, especially if the subfloor needs repair once the old floor is out.

10x10 Kitchen Remodel Labor Cost and the Real Timeline

Licensed contractor installing white shaker cabinets during a 10x10 kitchen remodel labor cost project, with drill, tool belt, quartz countertops, and subway tile backsplash visible

The 10×10 kitchen remodel labor cost typically takes 20 to 50 percent of the project. The gap between 20 and 50 comes mostly from one question: are you moving plumbing and electrical, or leaving them where they are? A kitchen that keeps its sink and range in place can be lean on labor. One that shifts them needs more trades, more inspections, and more days.

The timeline matters just as much, because delays cost money. A mid-range job commonly runs 6 to 12 weeks. Semi-custom and custom cabinets can take weeks to months to arrive, so ordering early protects your schedule. Here’s how work and payments usually flow:

  1. Contract signing. In California, a down payment generally can’t exceed 10 percent of the contract or $1,000, whichever is less. Confirm the current rule before you sign.
  2. Demo and rough-in (weeks 1 and 2). Old kitchen out, plumbing and electrical roughed in, inspection if a permit applies.
  3. Walls, flooring and cabinets (weeks 3 to 6). The first large progress payment usually lands here.
  4. Counters, backsplash and fixtures (weeks 6 to 9). Counters are templated after cabinets are set, which often creates a one to two week wait.
  5. Final connections and punch list. Hold back a final payment until every item is done.

If a contractor asks for large payments before work begins, treat it as a red flag.

San Diego Factors That Move Your Price

Local conditions change quotes more than most homeowners expect. Before you compare numbers, check these:

  • Permits. Swapping cabinets and counters in place often needs none. Moving a sink, adding circuits, or opening a wall usually does. Fees vary by project scope.
  • Energy code lighting. California’s Title 24 sets high-efficacy lighting requirements for kitchens, so older fixtures may not be replaceable one for one.
  • Older homes. Houses built before 1980 may need lead or asbestos testing. Outdated wiring, small electrical panels, and old pipes tend to show up once walls are open.
  • Coastal air. Near the water, hardware and finishes corrode faster, so material choices matter.
  • Local labor rates. Skilled trades here cost more than the national averages in most online guides.

If you want a sense of how these pieces fit into a full project, our San Diego Kitchen Remodeling Services page walks through the process from first visit to final walkthrough.

The Quote Audit: 10 Lines Every Estimate Should Show

A single line reading “kitchen remodel, $42,000” tells you nothing. Before you sign, make sure the estimate spells out:

  1. Demolition and disposal
  2. Cabinets by linear foot, with grade and construction named
  3. Countertop square footage, material, edge profile and fabrication
  4. Plumbing work, itemized
  5. Electrical work, itemized, including any panel change
  6. Permit fees and who handles the permit
  7. Appliance allowance versus actual selections
  8. Flooring, including subfloor repair
  9. Drywall, paint and trim
  10. Contingency rules, change order pricing, payment schedule, and start and finish dates

Picture two quotes for the same kitchen, one $9,000 lower. The cheaper one may simply leave out lines 5, 8, and 9. Two quotes only compare fairly when both contain all ten.

The Hidden 15% Nobody Puts in the Estimate

Even a clean quote leaves out costs that belong in your budget:

  • Living without a kitchen. Eating out or setting up a temporary kitchen for several weeks adds real money.
  • Contingency. Keep 10 to 20 percent in reserve. Old wiring and water damage behind cabinets are common surprises.
  • Design fees. A designer can cost a few thousand dollars, but often prevents expensive layout mistakes.
  • Price holds. Material pricing can shift between signing and ordering.
  • Change orders. Every “while we’re at it” costs more once work has started. A change order is a written price for any scope change after the contract.

Smart Ways to Lower the Cost Without Lowering Quality

You don’t have to cut corners to cut cost:

  • Keep plumbing and gas where they are. Relocating a sink or range is one of the quickest ways to inflate a 10×10 kitchen remodel cost.
  • Reface when boxes are sound. It’s often the largest single saving.
  • Mix cabinet grades. Use sturdier cabinets where wear is heavy and simpler ones where it’s light.
  • Skip a fixed island. A closed 10×10 can’t hold the 36 to 42 inches of clearance an island needs on every side. A rolling cart or a peninsula in an open plan gives prep space without crowding the room.
  • Don’t over-improve. Spending far above what nearby homes support rarely pays back at resale.

The Bottom Line

Your 10×10 kitchen remodel cost is a starting point, shaped by scope, materials, your home’s age, and how clearly the quote is written. Know your tier, ask for the ten lines above, keep a real contingency, and protect your layout where you can. When you’re ready for a written, line-by-line estimate, contact us and San Diego Home Remodeling will walk through your kitchen with you.

Frequently Asked Questions

What is the biggest cost in a 10×10 kitchen remodel?

Cabinets, usually 30 to 40 percent of the budget. Stock options start around $2,000 to $5,000, while fully custom ones can exceed $20,000.

Is cabinet refacing worth it for a 10×10 kitchen?

Yes, if the existing boxes are sturdy and you’re happy with the layout. Refacing keeps the 10×10 kitchen renovation cost down while giving a very different look.

How long does a 10×10 kitchen remodel take?

Most mid-range projects take 6 to 12 weeks. Cabinet lead times and counter templating cause most of the delays.

What hidden costs should I plan for?

Set aside 10 to 20 percent for surprises like water damage or outdated wiring. Also plan for permits, temporary kitchen costs, and change orders.

Is a 10×10 kitchen remodel worth the money?

Often, especially mid-range work that matches your neighborhood. Resale return varies by market, so avoid spending well above what nearby homes support.

Picture of John Thomas

John Thomas

John Thomas is a recognized expert in the home remodeling and renovation industry, with over 23 years of experience helping homeowners transform their spaces. His deep understanding of design, craftsmanship, and functionality fuels his passion for creating homes that reflect comfort and style. John's expertise and insight are evident in his contributions to the San Diego Home Remodeling blog, where he shares practical advice, design inspiration, and remodeling tips. Through his work, he continues to guide homeowners toward smarter renovation choices and lasting results.

Working Hours

Mon 8:00 AM - 6:00 PM

Tue 8:00 AM - 6:00 PM

Wed 8:00 AM - 6:00 PM

Thu 8:00 AM - 6:00 PM

Fri 8:00 AM - 6:00 PM

Sat 8:00 AM - 5:00 PM

Sun Closed

Copyright © San Diego Home Remodeling 2026. All Rights Reserved Powered by LocalPro1.

Scroll to Top
Seraphinite AcceleratorOptimized by Seraphinite Accelerator
Turns on site high speed to be attractive for people and search engines.
